Labor and the apprenticeship requirement: prevailing wage compliance as a project risk

How prevailing wage and apprenticeship requirements under the IRA are reshaping labor compliance from a cost line into a condition of project success

Subscribe to newsletter

Renewable project risks have traditionally fallen into a few familiar buckets: interconnection delays, permitting uncertainty, financing conditions. Labor was historically treated as just a cost, not a core factor in project success. But the introduction of the IRA changed this, directly tying prevailing wage and apprenticeship requirements to federal tax incentives. Labor compliance has become a prerequisite for capturing project revenue, and a project that’s permitted, engineered, and constructed can still fall short of its modeled returns if compliance isn’t executed and documented correctly.

Labor compliance used to operate in a sort of gray zone, with rules loosely defined and enforced. Projects could lean on this ambiguity in various ways: contractors had more leeway in how roles were classified and paid, documentation could be reviewed after the fact, and audits were infrequent. In most cases, a good-faith effort to comply with the requirements was enough.

But that buffer has been taken away. Rules are now clearer, and enforcement is more data-driven, with regulators looking for consistent, auditable records like certified payroll, worker classifications, and documented apprenticeship hours across the full contractor chain. Noncompliance can lead to back wage payments, penalties, delayed tax equity funding, or indemnities.

If your project touches federal dollars or IRA tax credits, prevailing wage and apprenticeship compliance is not optional—it’s a condition of the deal. The good news is that project owners who take the right steps early and stay actively engaged during construction can manage this risk effectively.

Before the project starts

Prior to breaking ground, the most effective way to reduce labor compliance risk is to build it into a project’s structure and planning. This starts with the EPC contract: compliance obligations, reporting requirements, and audit rights should be clearly defined, not left to general flow-down language.

Project Sponsors should establish a monitoring cadence upfront, pinpointing who’s responsible for oversight, how often compliance will be reviewed, and what data will be required. Contractors and subcontractors should be identified early, with apprenticeship requirements embedded into bid documents and subcontracts, and preference given to partners with strong compliance track records. The Project Sponsor should have a conversation with the EPC and subs, making sure they understand the requirements and are equipped to comply.

It’s also important to have a clear wage rate baseline. This prevents inconsistencies from spreading across contractors and creates a reference point for tracking rate updates during the project lifecycle. Teams should document and agree upon prevailing wage rates when a project starts, and build in a process for monitoring updates.

Before the first shovel hits the ground, projects should choose which compliance tracking and payroll monitoring system they’ll use. Labor data is generated as soon as construction starts, and having a system in place turns compliance into a managed process instead of a catch-up exercise. It also forces alignment across EPCs and subcontractors.

When construction is underway

As soon as construction starts, the EPC becomes the main driver of labor compliance; since they’re overseeing subcontractors on a day-to-day basis, they’re not only in the best position to report on compliance status in real time, they’re required to do so.

Project owners should have standing weekly or biweekly meetings with EPCs, not just occasional check-ins. Meetings should cover the apprenticeship ratio status across subcontractors; certified payroll submission status and any gaps or discrepancies; any new subcontractors or scope additions; open items from prior audits or reviews; and upcoming work phases that may introduce new classifications or wage obligations. Keeping a written record of these meetings is important too, since the documentation itself is evidence of active oversight.

Alongside structured check-ins, effective compliance depends on having real-time visibility into project data; the days of collecting paper-based certified payrolls and reviewing them weeks later are over. Payroll data should be submitted digitally and reviewed on a rolling basis, not just at milestones.

Projects should have dashboards that track apprenticeship and wage status by contractor, and automated flags for missing or inconsistent data. Again, this shift isn’t just about catching issues earlier; it shows regulators that continuous oversight was in place.

Finally, any meaningful changes during construction—such as new subcontractors, a new funding source, or updated wage determinations—should trigger a compliance review before work starts to make sure requirements stay aligned as the project evolves.

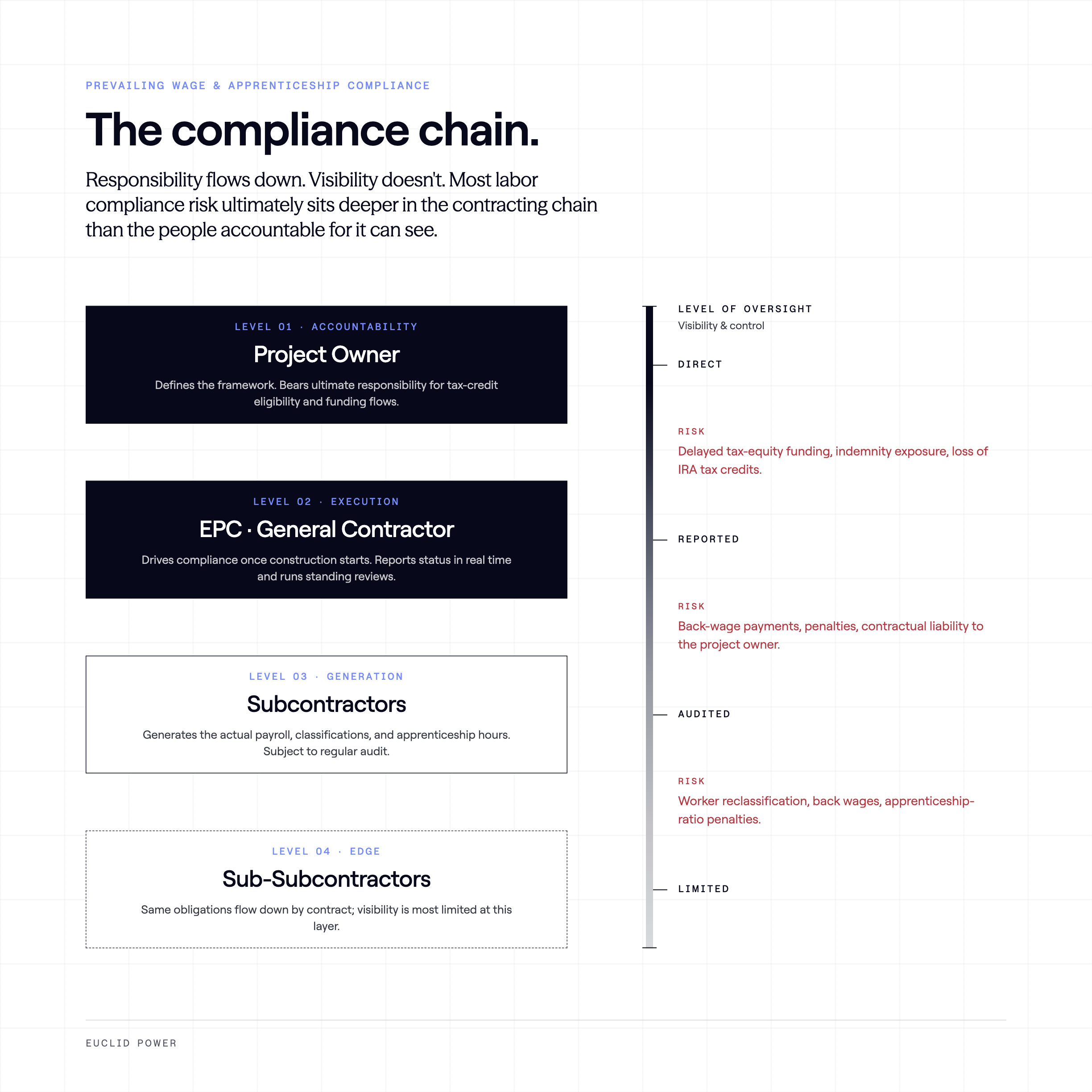

Subcontractor risk: the chain of liability

Even with strong oversight at the EPC level, most labor compliance risk ultimately sits deeper in the contracting chain. The EPC may coordinate the work, but payroll data, worker classifications, and apprenticeship hours are generated by multiple layers of subcontractors. Responsibility may be clear in contracts, but visibility is often uneven in practice.

That’s why flow-down clauses matter so much: they ensure subcontractors are held to the same prevailing wage, apprenticeship, and reporting requirements as the EPC, and they protect the EPC and project owner if any issues come up. Subcontractor payroll and apprenticeship records should be reviewed in regular audits to spot any problems while work is still ongoing.

If a subcontractor is out of compliance, they should immediately remedy the issue, whether by fixing payroll records, reclassifying workers, updating wage rates, or making back wage payments. There’s also a penalty for not employing apprentices. Early detection is key; delayed discovery makes remediation harder, more expensive, and more likely to affect the overall project.

Apprenticeship requirements as a workforce strategy

Apprenticeship requirements tend to be seen as a compliance rule, but they should really be treated as part of workforce planning. Consistently meeting required ratios depends less on end-of-project reporting and more on how labor is sourced, scheduled, and coordinated from the start.

One of the most reliable approaches is to establish relationships with registered apprenticeship programs long before the first shovel hits the ground. This helps ensure there’s enough qualified apprentices to meet ratio requirements across different phases of work, especially in specialized trades where supply can be limited. Apprenticeship ratios should be tracked in real time instead of waiting until project closeout, as teams can then adjust staffing before gaps become compliance issues.

If a project can’t meet apprenticeship requirements despite actively trying to comply, it may get a good faith effort exception, but has to show it tried to meet the requirement. This proof could be in records showing outreach to registered apprenticeship programs, recruitment efforts through contractors and staffing partners, documentation of apprenticeship availability constraints in the project region, or logs showing attempts to improve ratios during construction. It also helps to show that the issue was addressed in real time, not discovered at the end of the project.

Responding to a compliance finding

When a labor compliance issue comes up and triggers an audit or investigation, project owners should focus on clarity, coordination, and documentation. Start by putting together a complete, accurate record of the project’s labor data, including certified payroll, subcontractor documentation, apprenticeship tracking data, and any relevant contract terms to understand where the issue originated and how widespread it may be. From there, teams typically engage directly with the relevant contractors—often the EPC and affected subcontractors—to confirm what happened and begin corrective action.

How well a project responds in this moment depends on what was in place during construction. Strong real-time monitoring systems and consistent EPC oversight meetings can make a significant difference, as they create a documented record of active management. If there are logs showing regular review of payroll submissions, apprenticeship ratios, and subcontractor status, it’s easier to show that compliance was being actively managed.

Remediation options usually include correcting payroll records, issuing back wage payments where required, or paying penalties. Delays in resolving these types of issues can affect funding flows or trigger additional scrutiny from tax equity partners, so protecting the project timeline and tax credit eligibility is a central concern during this phase. Projects with clear, time-stamped documentation of oversight and execution are in a far stronger position than those relying on reconstructed explanations after the fact.

From contract structure and workforce planning to real-time monitoring and subcontractor oversight, the projects that perform best treat labor compliance as an integrated system rather than a final checkpoint. As enforcement becomes more data-driven and expectations continue to rise, success depends on producing clear, consistent records showing requirements were met throughout the project.

Enjoying this deep dive?

Stay up to date on market insights for teams who build, buy, and finance renewable projects.

Subscribe to newsletter

IN THE NEWS

North Carolina’s pause on solar spurred by climate rollback.

On April 23rd, the North Carolina Utilities Commission paused new solar procurement for 2026, delaying 770 megawatts of solar development until Duke Energy's long-term Integrated Resource Plan is approved this winter. The decision follows the state legislature's 2024 rollback of a 2030 interim carbon reduction target, which the commission cited as a reason to hold off on locking in new renewable projects. Solar developers and project financiers face significant near-term uncertainty, as the pause signals a potential shift toward fossil fuels at a time when data center growth is driving substantial new electricity demand.

Read more

Virginia’s new law blocks counties from banning solar.

Virginia Governor Abigail Spanberger has signed a law voiding county-wide bans on utility-scale solar development, set to take effect July 1. Nearly two-thirds of Virginia's counties previously banned or heavily restricted large solar farms, creating a significant barrier in a state that mandates 100% renewable energy from its largest utilities by 2050. Local governments retain the ability to deny individual project permits, but must now submit their reasoning to state regulators. The law opens up large portions of the state that were previously off-limits.

Read more

More than 67 GW storage, 14 GW solar seek interconnection in PJM’s reopened queue.

PJM Interconnection has reopened its standard interconnection queue, receiving 811 project applications totaling significant capacity across fuel types, with natural gas leading at 106 GW, followed by storage at 67 GW, solar at 15 GW, and solar-plus-storage at 9 GW. The revamped process uses a first-ready, first-served approach requiring upfront financial commitments and demonstrated site control, replacing a prior system criticized for enabling speculative applications that created a large backlog. For solar and storage developers active in the PJM region, the queue's reopening is a key milestone, though the region remains significantly behind single states like California and Texas in deployed clean energy capacity. Regulators acknowledged that many projects with signed interconnection agreements face additional delays from state permitting hurdles and supply chain constraints once they clear the queue itself.

Read more

Introducing Euclid Tax Credit Compliance

The One Big Beautiful Budget Act created a new compliance reality: FEOC, Domestic Content, and PWA requirements that billions in tax credits now depend on.

We spent the past year building the solution. Today, we're launching it publicly.

Euclid Tax Credit Compliance gives developers, lenders, tax equity, insurers, and legal counsel a single defensible record to operate from. We've already supported 1+ GW across all three compliance tracks.

Learn more →

Never miss a newsletter.

Subscribe to market insights for teams who build, buy, and finance renewable projects.

Subscribe to newsletter
